Using Intelligent Scenario Modelling to Balance Carbon, Cost and Asset Risk

Picture of Vianney AIRAUD vianney.airaud

Vianney AIRAUD vianney.airaud

Related Blogs

If I plan carbon, cost, and asset risk separately, I usually get the wrong answer. The article’s main point is simple: I need to test capital choices side by side across the same time frame, using the same asset data, budget limits, risk rules, and emissions targets.

Here’s the short version:

  • Old assets are a big issue: more than 80% of U.S. buildings were built before 2000, and public infrastructure has about $1 trillion in deferred maintenance.
  • Single forecasts are weak: one cost path, one energy price path, and one failure curve can break fast.
  • Scenario modelling works better: I can compare refurbish vs. replace, defer vs. act now, and shallow vs. deep vs. staged retrofits before I commit money.
  • Good inputs matter: asset condition, age, repair history, energy use, utility costs, and CO2e factors all shape the result.
  • The end goal is not a forecast: it’s a ranked multi-year CAPEX plan with documented trade-offs.

A few examples from the article make the point clear:

  • A do-minimum chiller path had the lowest upfront spend, but the highest risk and highest carbon over time.
  • Deferring a $1,000,000 hospital roof replacement pushed 10-year cost to about $1,300,000, or 30% more than acting now.
  • At the portfolio level, a staged retrofit path often fits U.S. annual budget cycles better than all-at-once deep work, while still cutting CO2e and risk over time.

What I take from this: the best capital plan is usually not the cheapest in year one. It’s the option that holds up when I test budget pressure, failure risk, and emissions goals together.

Decision area Main options compared What to measure
Single asset renewal Do-minimum, refurbish, replace CAPEX, OPEX, failure cost, CO2e, risk
Timing Act now, defer, wait for failure 10- to 30-year cost, downtime, failure chance, emissions
Portfolio retrofit Shallow, deep, staged Total CAPEX, CO2e cuts, risk drop, rollout timeline
Project ranking Fund now vs. later Risk reduction per $1,000, net present cost, carbon benefit per $1,000

In short, this article shows how I can move from scattered asset data and one-off budget calls to a documented CAPEX plan that finance, operations, and audit teams can all follow.

Step 1: Build the data and rules for scenario modelling

Before you run any scenario, you need a solid baseline. If the asset data is shaky, every result that comes out of the model will be shaky too. If you want to compare options in a way people can trust, start with clean asset data and clear decision rules.

Create a reliable asset baseline with condition, cost, and energy data

Simeo Inventory pulls asset data from CMMS, GIS, ERP systems, and spreadsheets into one standard hierarchy: portfolio → site → building → system → component. Each asset record should have a unique ID, location, age or installation date, expected service life, and a criticality rating tied to safety, operations, and regulatory exposure.

Each asset entry also needs replacement cost in current U.S. dollars, annual maintenance spend, and repair history. For energy and carbon, any asset that uses energy should include annual electricity use in kWh, utility cost assumptions in $/kWh, and a baseline emissions factor based on the regional grid mix in lb CO₂e/kWh. Most teams pull together 12 to 36 months of utility data and normalize it by floor area in kWh/ft²/year. That gives you the baseline every retrofit scenario will be measured against.

Condition data should use one scale across the board, such as 1 to 5 or Good/Fair/Poor. Capture it at the component level and include inspection dates in U.S. format, like 03/15/2026. It also helps to add fault logs and mean time between failures. Two assets can have the same condition rating on paper, yet behave very differently in the field. That extra detail helps the model spot stronger failure signals.

Once the baseline is steady, set the rules the model is not allowed to break.

Set decision rules for risk, budget, and carbon constraints

Risk rules set failure thresholds for critical assets and allow zero tolerance for life-safety failures. Budget rules define annual CAPEX limits. Service rules define the minimum performance level assets must meet. Carbon targets should be turned into annual milestones so the model can test whether a given path is accelerated, delayed, or simply infeasible under the budget and risk limits.

In Oxand Simeo™, these rules become hard constraints during optimization, so the engine solves for an asset-level plan that fits the carbon budget, the CAPEX cap, and the reliability target at the same time [2]. Plans that miss the risk, budget, or carbon target are screened out before ranking starts.

A big part of this comes down to deterioration modelling. Oxand Simeo™ uses a library of 10,000+ proprietary aging models and 30,000+ maintenance actions [1] to estimate how each asset class degrades over time. Use calibrated deterioration curves to project failure likelihood year by year. That gives you a year-by-year failure profile instead of one fixed replacement date.

With the inputs and constraints in place, you can start testing the investment paths that matter.

Configure scenarios in Oxand Simeo™

Set up scenarios by changing specific levers tied to the choice you want to test. That can include intervention timing, like replacing a chiller in 2028 instead of 2033. It can also include refurbishment depth, such as a light refurbishment that extends service life by 5 years versus a deep one that extends it by 10. You can test phased retrofit schedules, annual budget caps, energy-efficiency levels, and technology choices like gas-fired boilers versus electric heat pumps.

Keep the baseline data and outputs the same across every scenario. Use one baseline, the same metrics – CAPEX, lifecycle OPEX, annual CO₂e, and risk score – and then compare contrasting scenarios such as risk-minimizing, budget-minimizing, and carbon-maximizing. That way, you can see how each lever changes the trade-off.

With the baseline and rules in place, the next move is to compare the investment choices that shift the portfolio the most.

Step 2: Compare the investment choices that matter most

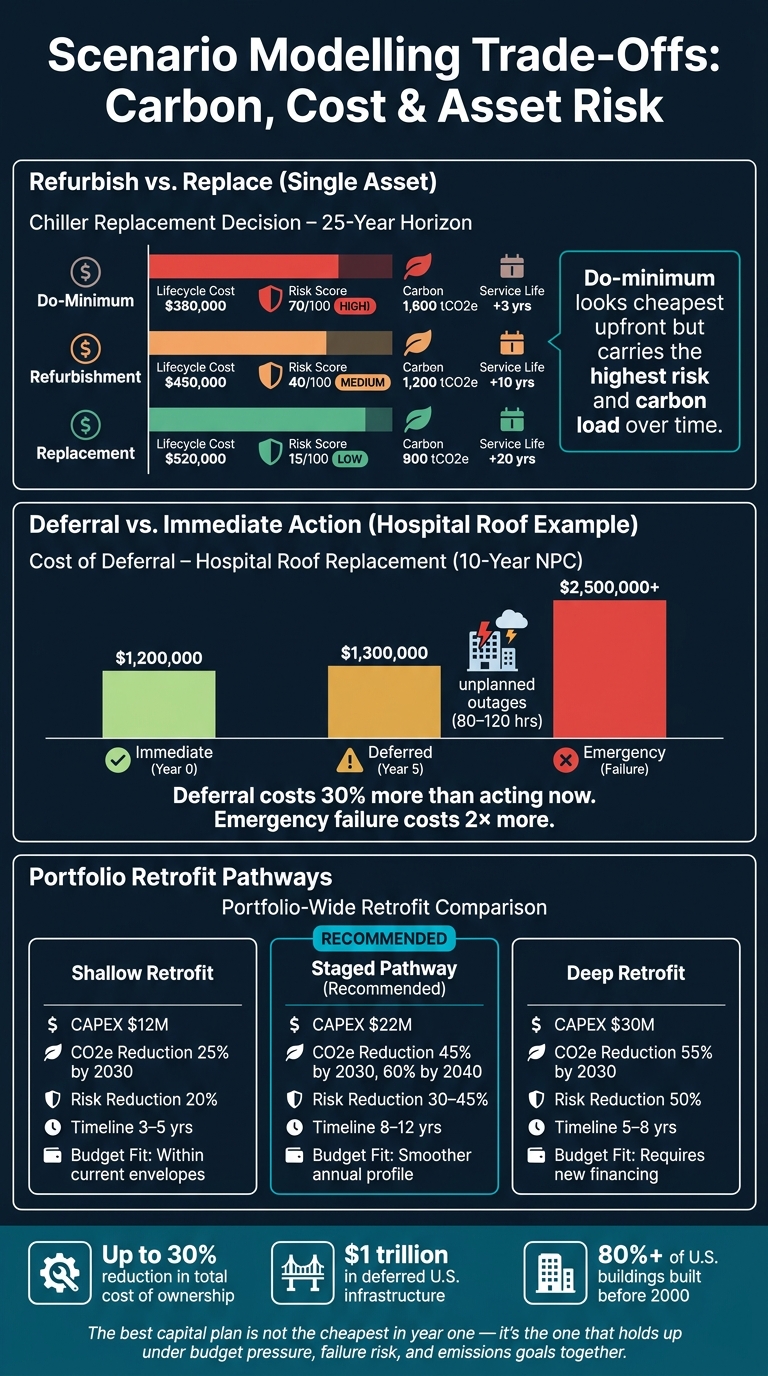

Carbon, Cost & Risk: Scenario Modelling Trade-Offs for Capital Planning

Carbon, Cost & Risk: Scenario Modelling Trade-Offs for Capital Planning

Once you have baseline data and decision rules, the next job is to compare the options that shape the biggest calls. In most portfolios, the same three scenarios show up again and again: refurbish or replace, defer or act now, and choose between shallow, deep, or staged retrofit paths across the portfolio.

The method should stay the same each time: use consistent metrics, set a clear time horizon, and show the full trade-off – not just the day-one price tag.

Refurbishment vs. replacement

It’s easy to see why teams lean toward replacing old assets. But that move can drive embodied carbon and CAPEX up, even when refurbishment would have gotten you close to the same outcome.

A better comparison puts three options side by side: do-minimum, refurbish, and replace. Each one should be tested over the same 25- to 30-year horizon using net present cost (NPC) in U.S. dollars.

For each option, include:

  • Initial CAPEX
  • Projected OPEX, including maintenance and energy
  • Failure costs
  • Carbon from both embodied CO2e and operational CO2e
  • Risk scores before and after the intervention

That gives you a clearer picture of what you’re buying – and what you’re avoiding.

Take an aging chiller in a U.S. office building. A do-minimum approach keeps short-term spending down, but the asset stays inefficient and keeps piling up operational carbon and failure risk. Refurbishment extends service life at a moderate cost and comes with lower embodied carbon than full replacement. Replacement gives you the strongest long-term risk position and the lowest operational emissions, but it also brings a bigger embodied carbon hit at year zero.

Option Lifecycle Cost (NPC) Risk Score (0–100) Carbon Impact (tCO2e) Service Life Gained
Do-minimum $380,000 70 (High) 1,600 3 years
Refurbishment $450,000 40 (Medium) 1,200 10 years
Replacement $520,000 15 (Low) 900 20 years

This table shows the trade-off in plain terms. Do-minimum looks cheapest at first glance, but across the planning horizon it brings the highest risk and the heaviest carbon load. Refurbishment often lands in the middle for a reason: lower embodied carbon than replacement, a solid drop in risk, and a service life bump that can fit an actual budget. Replacement tends to make more sense when risk is already severe, compliance is on the line, or the new asset sharply cuts energy use.

Deferral vs. immediate intervention

Deferral can look like a budget move. In practice, it’s a risk move – and carbon comes with it.

When a high-risk asset gets pushed out a few years, you’re not only delaying CAPEX. You’re also taking on a higher chance of failure, more exposure to emergency repair costs, and more years of poor performance that keep operational emissions high.

The model here starts with time-based failure probability curves for each asset. Then it adds the financial impact. Emergency repair costs often run 1.5× to 3× the cost of a planned intervention because of overtime labor, rushed parts, and collateral damage. On top of that, you have downtime impacts, whether measured in hours offline or lost revenue, plus any code-related exposure tied to non-compliance.

Think about a critical roof system on a U.S. hospital that is nearing end of life. Replacing it now, at year zero, costs $1,000,000 in planned CAPEX, keeps downtime low, and drops risk from high to low right away. Deferring to year five starts with $50,000 in patch repairs, but it also brings an estimated $400,000 in emergency costs over five years, 80 to 120 hours of unplanned downtime, and higher operational emissions from weak thermal performance. Over 10 years, the total cost of deferral climbs to about $1,300,00030% more than acting now.

Intervention Timing Cumulative Cost (10-Year NPC) Risk Trend Carbon Trend Service Impact
Immediate (Year 0) $1,200,000 High → Low Moderate embodied, low operational Planned downtime only
Deferred (Year 5) $1,300,000 High → High → Low Low embodied now, high operational until replacement Unplanned outages likely
Emergency (Failure) $2,500,000+ Critical Peak inefficiency emissions Major service disruption

This pattern shows up across many asset types. Deferral may ease year-one CAPEX pressure, but by year five or year 10 it usually costs much more. For high-risk, high-criticality assets, scenario modeling makes that future bill hard to ignore before the choice gets baked in.

Portfolio-wide retrofit pathways

Once you zoom out from single assets to the whole portfolio, the question changes. It’s no longer, Which option is best for this one asset? It becomes, Which sequence of interventions cuts the most carbon and risk within our annual budget?

To answer that, group assets by type, condition band, energy use intensity (kBtu/ft²/year), and criticality. Then compare three portfolio paths: shallow, deep, and staged.

A shallow retrofit spreads lower-cost measures across many assets. That usually means controls upgrades, lighting replacements, and basic HVAC tuning. It can fit inside current CAPEX envelopes and move fast, but the carbon and risk gains are limited.

A deep retrofit goes much further. It targets full system replacement and major envelope upgrades. That path delivers the biggest CO2e cuts, but it also needs more funding and a longer rollout.

A staged path does both over time. It starts with shallow measures, then moves into deeper upgrades as assets reach end of life. That spreads CAPEX across budget cycles while still moving the portfolio toward meaningful carbon targets.

Pathway Total CAPEX Cumulative CO2e Reduction by 2030 Avg. Risk Reduction Implementation Timeline Budget Fit
Shallow Retrofit $12,000,000 25% vs. baseline 20% 3–5 years Within current envelopes
Deep Retrofit $30,000,000 55% vs. baseline 50% 5–8 years Requires new financing
Staged Pathway $22,000,000 45% by 2030; up to 60% by 2040 30% by 2030, 45% by 2040 8–12 years Smoother annual profile

For many U.S. portfolios working under annual CAPEX limits, the staged pathway tends to perform well. It lines up high-impact work with asset end-of-life cycles, avoids premature replacements, and creates a CAPEX pattern that fits standard corporate and public budgeting cycles. Deep retrofits deliver the strongest carbon and risk results, but they need a clear financing plan. Shallow retrofits can be the right place to start when budgets are tight and quick wins matter, though they rarely get a portfolio all the way to aggressive carbon goals on their own.

Step 3: Turn scenario results into a prioritized CAPEX plan

Once you’ve picked the scenario that best balances carbon, cost, and risk, the next step is to turn it into a ranked funding plan.

After comparing scenarios, move from analysis to an approval-ready CAPEX plan. Use dashboards to compare risk, lifecycle cost, and carbon across a 5- to 20-year period. Then group projects by asset class, risk, and deadline. From there, turn the selected pathway into annual funding by fiscal year and budget cap. The last step is packaging everything into governance-ready documentation: a ranked project list, year-by-year CAPEX estimates, and a clear reason for why that scenario was chosen.

Rank projects using risk-cost-carbon trade-offs

Not every project should get the same level of urgency. If you rank work using only one metric – like lowest cost or worst condition score – you can end up making bad calls.

A better method blends three indicators:

  • Risk reduction per $1,000 of CAPEX
  • 20- to 30-year net present cost
  • Carbon benefit per $1,000 invested

In Oxand Simeo™, these indicators are calculated from asset condition data, degradation models, cost curves, and energy and carbon data. They’re then shown as sortable lists or heatmaps. That makes it much easier to spot which projects deliver the most risk reduction inside a fixed budget, or which ones give you the lowest cost per ton of CO₂e abated, before you layer in internal priorities like critical facilities or public safety needs.

That ranking isn’t just for show. It becomes the actual annual CAPEX sequence.

This helps you avoid two common traps: reactive spending and blanket deferral. In plain English, that means funding recent failures instead of future risk, or pushing everything out without checking the downstream cost.

For example, delaying a roof replacement on a low-risk storage building may do little harm. Delay structural repairs on a bridge, though, and risk exposure plus future rehabilitation cost can climb fast. The same logic applies to energy work. If you put off retrofits in a high-consumption public hospital, you delay major CO₂e savings and lock in higher operating costs. Scenario modeling makes those trade-offs visible and easier to defend.

Produce audit-ready evidence aligned with ISO 55001

ISO 55001

A ranked project list is only as strong as the evidence behind it.

ISO 55001 requires organizations to show that investment decisions are systematic, traceable, and tied to defined asset management objectives – not driven by gut feel or budget convenience. Oxand Simeo™ also generates ISO 55001 audit trails and reports to cut evidence-preparation time.

Once projects are ranked, traceability becomes the next job. Each project file should include:

  • the baseline assumptions: asset register, condition data, cost libraries, and carbon factors with version control
  • the scenario definitions that explain what each option means and which rules were applied
  • the ranking criteria used to choose interventions
  • the chosen option and alternatives considered, backed by risk-cost-carbon comparisons
  • the expected outcomes, including measured changes in risk, lifecycle cost, and annual CO₂e emissions over the planning horizon

Oxand Simeo™ creates traceable records that connect each investment recommendation back to the underlying asset condition, risk calculations, cost estimates, and carbon data, along with scenario settings and decision logs. So an internal reviewer or external auditor can move from a portfolio summary down to a single project and see exactly why that intervention was recommended, what it costs, and what it helps avoid.

Treat the CAPEX plan like a version-controlled working document. Re-run scenarios when inspection data, cost libraries, or regulations change, and keep prior versions for audit.

Conclusion: Use scenario modelling to defend decisions under uncertainty

Waiting doesn’t make capital decisions easier. Scenario modelling makes them easier to defend, especially when you need to weigh carbon, cost, and asset risk at the same time.

When carbon targets, budget caps, and asset risk are modeled together, the trade-offs become much easier to see. Refurbishment versus replacement. Deferral versus immediate intervention. One retrofit path across the portfolio versus another. Instead of guessing, teams can act with a clear line of reasoning.

That’s why the final step isn’t another forecast. It’s a prioritized CAPEX plan. Organizations that use intelligent scenario modelling have cut total cost of ownership by up to 30% over the long term, while ISO 55001-aligned audit trails have reduced evidence-preparation time by as much as 70% [1][3]. The payoff is clear: lower ownership cost, faster audit prep, and stronger sustainability reporting.

Key takeaways for portfolio decision-makers

Four actions help move a portfolio from uncertainty to a CAPEX plan teams can stand behind.

  • Build clean baseline data. Condition assessments, cost libraries in USD, and energy baselines shape whether scenario outputs can be trusted.
  • Set decision rules early. That includes risk thresholds, annual budget caps, and carbon reduction targets.
  • Test multiple intervention pathways in Oxand Simeo™. Compare refurbishment versus replacement, deferral versus immediate action, and portfolio-wide retrofit sequences so the final choice comes from comparison, not assumption.
  • Turn results into a multi-year CAPEX plan. Include ranked projects, year-by-year funding needs, and documented reasoning that finance leaders and operations teams can both follow.

With that approach, each investment recommendation is traceable. Each trade-off is documented. And every stakeholder, from the board to the external auditor, can see why a decision was made and what it’s expected to achieve.

FAQs

What data do I need to start scenario modeling?

Start with a centralized asset inventory built on clean, standardized data.

For each asset, record:

  • current condition
  • lifecycle stage
  • energy use
  • risk level

That information can come from systems you already use, such as ERP, CMMS, or BIM, or from on-site inspections.

You also need clear planning inputs: objectives, constraints, and time horizons. That includes inflation-adjusted capital and operating budgets, along with carbon and reliability targets.

How do I choose between refurbishment and replacement?

Look past age-based assessments. Use scenario modeling to weigh refurbishment and replacement against your finance, carbon, and risk limits.

Start with an asset inventory that tracks condition, remaining life, emissions, and costs. Then model each option over 10 to 20 years. Compare low-budget, carbon-focused, and cycle-based replacement scenarios to see which mix gives you the best balance of savings, CO2e cuts, and risk while staying within budget and regulatory limits.

How often should I update the CAPEX plan?

Update your CAPEX plan every year. That gives you a clear way to compare modeled savings with actual performance, so the plan stays current and tied to what’s happening on the ground.

Revisit your rankings each year as conditions shift, budgets tighten or open up, and carbon targets change. This helps keep your investment strategy audit-ready and responsive to new information.
