Sustainable Investment Planning for Cities and Regions: Where to Start

Cities, departments and regions face a version of the asset planning problem that is harder than most private portfolios. The estate is diverse — schools, sports halls, offices, social housing, roads, bridges, water networks — with different technical logic and different funding rules. Budgets are annual and politically arbitrated. Deadlines are set externally. And the plan must be explainable to elected representatives and to the public.

That combination makes the temptation to start with a complete inventory very strong, and usually counterproductive: a full audit of every asset takes years, costs a great deal, and produces a dataset that is out of date in places before it is finished.

A more effective first step is narrower.

Start with one asset family, not the whole estate

Choose a family where three things are true: the assets are numerous enough for patterns to appear, similar enough to compare, and material enough that the answer changes a budget. School buildings are the classic starting point for a local authority — often the largest share of floor area, the largest energy consumer, and subject to renovation obligations.

Working within one family means the condition criteria, intervention options and unit costs are consistent, so the analysis is comparable and can be built in months rather than years. It also produces a result that transfers: the method proven on schools applies to sports facilities and offices with modest adaptation.

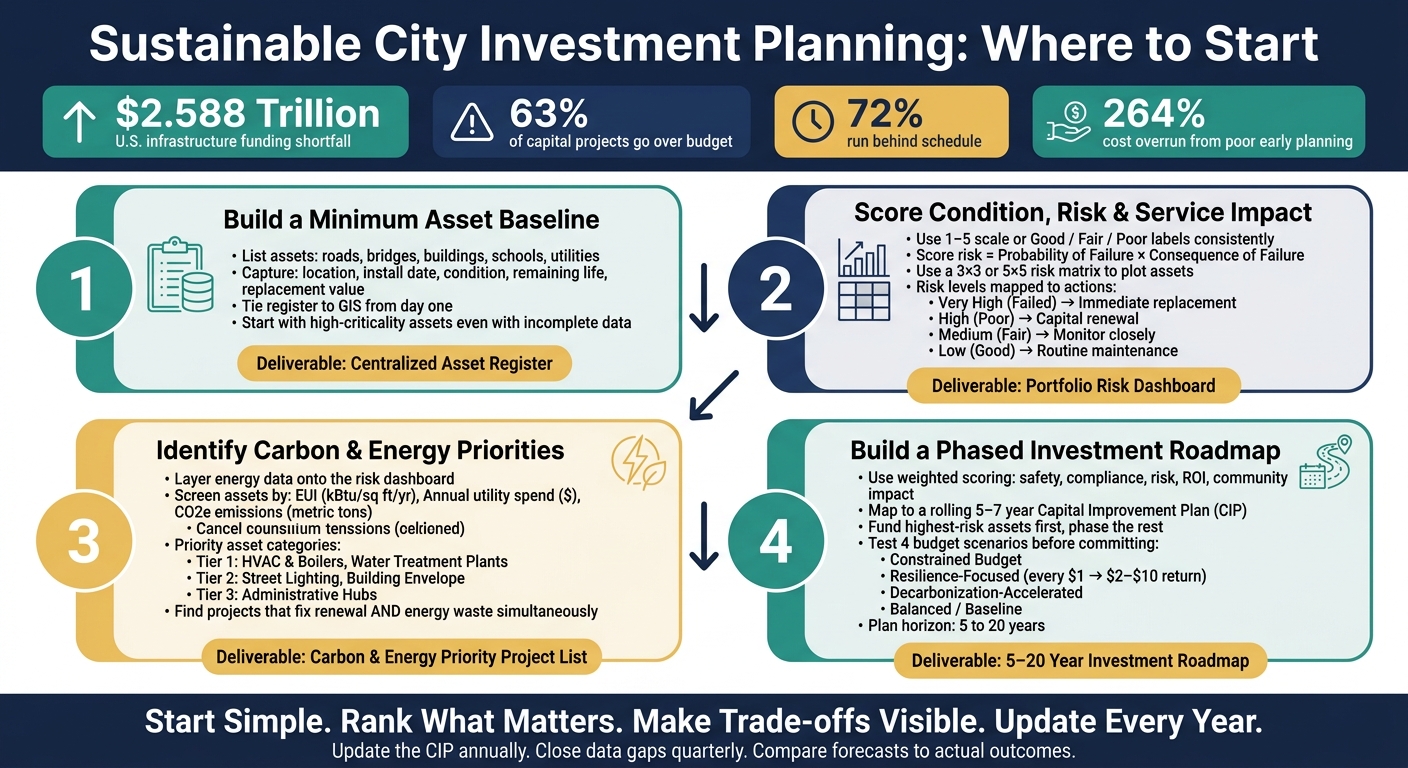

Build a condition baseline you can defend

The baseline does not need to be exhaustive. It needs to be consistent and evidenced. For each asset in scope: structural and envelope condition, technical systems, energy performance, and known regulatory exposure.

Two rules save a great deal of rework. First, score against written definitions, so two surveyors reach the same result. Second, record the source of every figure — a survey, a bill, a model estimate — because the plan will be challenged, and the answer to “where does this come from?” needs to exist.

Model trajectories, then phase across mandates

A baseline says where you are; it does not say when to act. Projecting each asset’s condition forward turns the baseline into a schedule, showing which assets reach an intervention threshold in which year.

That projection is what makes phasing possible — and phasing is the core political skill in public asset planning. A ten- or fifteen-year plan has to be delivered through successive annual budgets and across electoral mandates. A plan that requires a single large commitment will not survive; one that sequences work into affordable annual tranches, each defensible on its own terms, can.

Useful phasing tests:

  • Does each year fit the realistic envelope, including delivery capacity, not just funding?
  • Are regulatory deadlines met with margin, rather than in the final year?
  • Is high-criticality risk addressed early, so the plan is not exposed to a failure that discredits it?
  • Are interventions bundled by site, so mobilisation costs are shared?

Bring carbon and cost into the same decision

For public estates, energy and carbon are rarely optional considerations — they are attached to funding conditions and statutory obligations. Assessing them separately from the capital plan produces two documents that disagree.

The workable approach evaluates each intervention on cost, risk and carbon at once, so the trade-offs are visible: which renovations pay back, which are compliance-driven, and which would lock in emissions past a target date if done like-for-like.

Make the plan auditable

Public plans get scrutinised. The difference between a plan that survives scrutiny and one that does not is usually traceability: each recommended intervention linked to the condition evidence, the risk it addresses, its cost basis, and the alternative that was rejected.

This is where working in line with ISO 55001 practice pays off — not as a certification exercise, but because the standard’s emphasis on evidencing decisions is exactly what a public audit asks for. Oxand Simeo™ produces this trail as a by-product of the planning work: predictive models per asset, scenarios compared on cost, risk and carbon, and recommendations that carry their assumptions. More than 100 organisations, including many public asset owners, plan on this basis.

A realistic first six months

  1. Scope one asset family and agree the decision the plan must support.
  2. Assemble existing data — surveys, energy bills, maintenance history — and identify the gaps that matter.
  3. Survey to fill only those gaps, against written scoring definitions.
  4. Model condition trajectories and build two or three phasing scenarios.
  5. Present the scenarios with their cost, risk and carbon consequences, and let the arbitration happen with the evidence visible.

The output is a defensible multi-year plan for one part of the estate, and a method the authority can extend. That is a considerably stronger position than a complete inventory with no plan attached.
